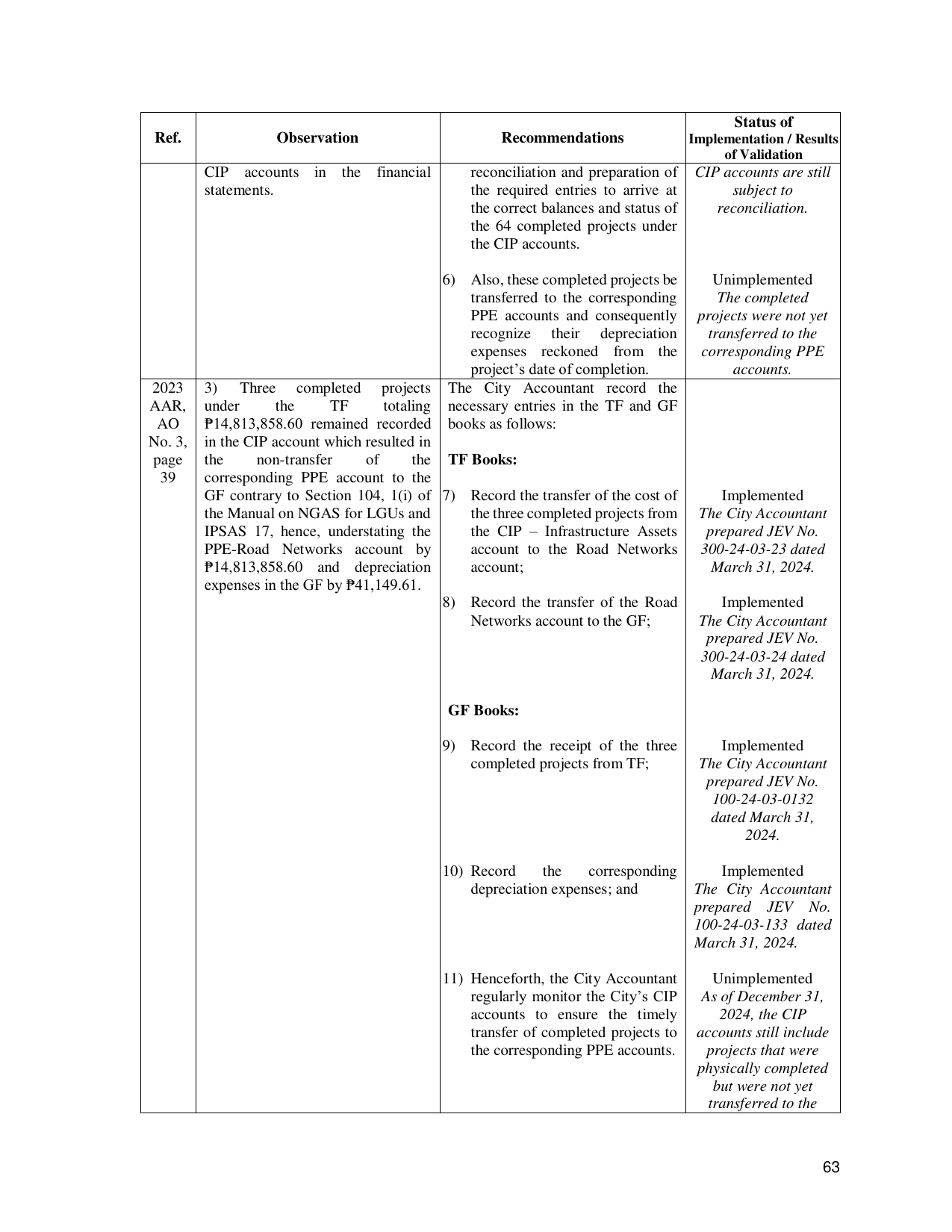

Page 70 of 88

Status of
Ref. Observation Recommendations Implementation / Results
of Validation
CIP accounts in the financial reconciliation and preparation of CIP accounts are still
statements. the required entries to arrive at subject to
the correct balances and status of reconciliation.
the 64 completed projects under
the CIP accounts.
6) Also, these completed projects be Unimplemented
transferred to the corresponding The completed
PPE accounts and consequently projects were not yet
recognize their depreciation transferred to the
expenses reckoned from the corresponding PPE
project’s date of completion. accounts.
2023 3) Three completed projects The City Accountant record the
AAR, under the TF totaling necessary entries in the TF and GF
AO ₱14,813,858.60 remained recorded books as follows:
No. 3, in the CIP account which resulted in
page the non-transfer of the TF Books:
39 corresponding PPE account to the
GF contrary to Section 104, 1(i) of 7) Record the transfer of the cost of Implemented
the Manual on NGAS for LGUs and the three completed projects from The City Accountant
IPSAS 17, hence, understating the the CIP – Infrastructure Assets prepared JEV No.
PPE-Road Networks account by account to the Road Networks 300-24-03-23 dated
₱14,813,858.60 and depreciation account; March 31, 2024.
expenses in the GF by ₱41,149.61.
8) Record the transfer of the Road Implemented
Networks account to the GF; The City Accountant
prepared JEV No.
300-24-03-24 dated
March 31, 2024.
GF Books:
9) Record the receipt of the three Implemented
completed projects from TF; The City Accountant
prepared JEV No.
100-24-03-0132
dated March 31,
2024.
10) Record the corresponding Implemented
depreciation expenses; and The City Accountant
prepared JEV No.
100-24-03-133 dated
March 31, 2024.
11) Henceforth, the City Accountant Unimplemented
regularly monitor the City’s CIP As of December 31,
accounts to ensure the timely 2024, the CIP
transfer of completed projects to accounts still include
the corresponding PPE accounts. projects that were
physically completed
but were not yet
transferred to the
63
