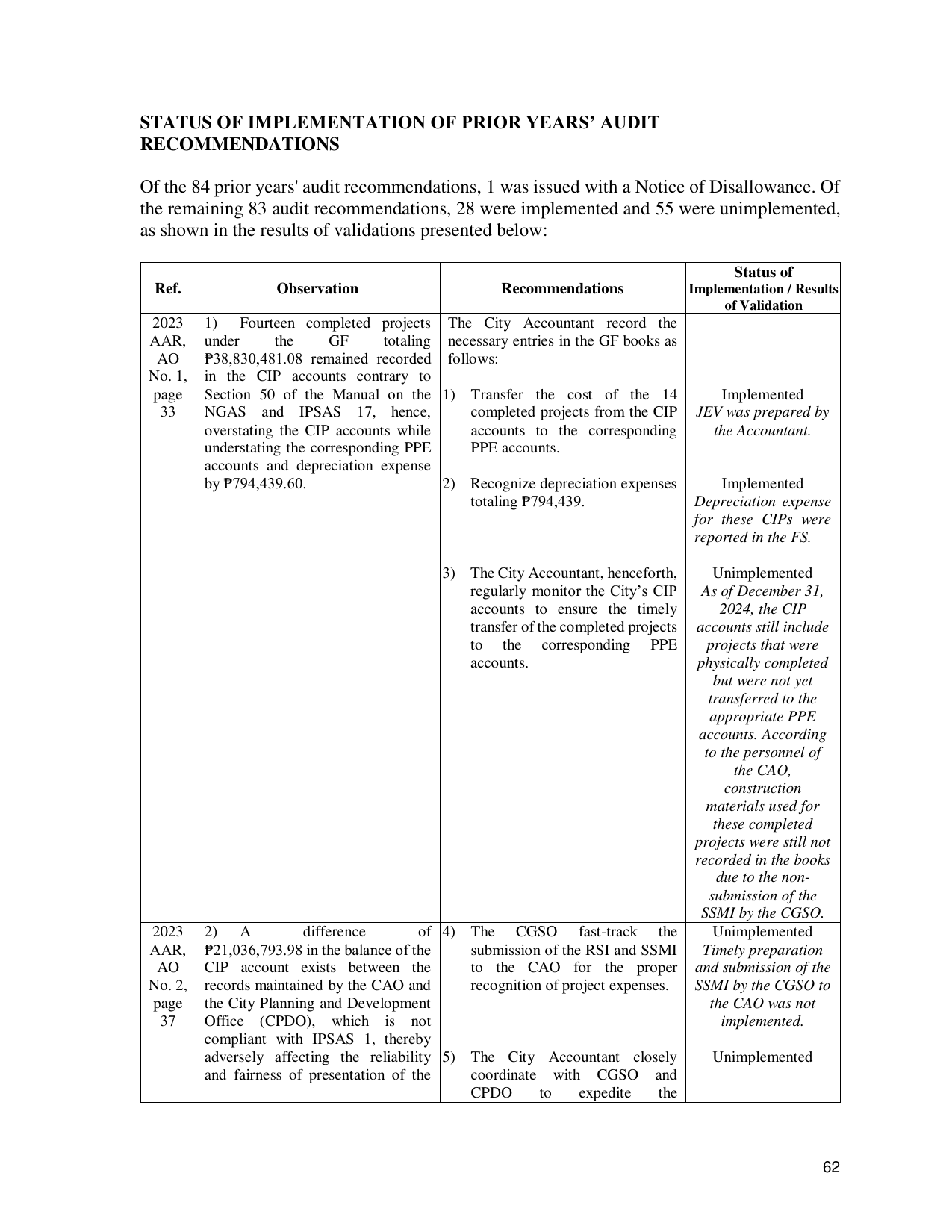

STATUS OF IMPLEMENTATION OF PRIOR YEARS’ AUDIT
RECOMMENDATIONS

Of the 84 prior years' audit recommendations, 1 was issued with a Notice of Disallowance. Of
the remaining 83 audit recommendations, 28 were implemented and 55 were unimplemented,
as shown in the results of validations presented below:

                                                                                             Status of
 Ref.                Observation                       Recommendations                Implementation / Results
                                                                                           of Validation
 2023     1) Fourteen completed projects The City Accountant record the
 AAR,     under      the      GF      totaling necessary entries in the GF books as
  AO      ₱38,830,481.08 remained recorded follows:
 No. 1,   in the CIP accounts contrary to
 page     Section 50 of the Manual on the 1) Transfer the cost of the 14                  Implemented
  33      NGAS and IPSAS 17, hence,               completed projects from the CIP      JEV was prepared by
          overstating the CIP accounts while      accounts to the corresponding          the Accountant.
          understating the corresponding PPE      PPE accounts.
          accounts and depreciation expense
          by ₱794,439.60.                      2) Recognize depreciation expenses         Implemented
                                                  totaling ₱794,439.                  Depreciation expense
                                                                                      for these CIPs were
                                                                                      reported in the FS.

                                              3) The City Accountant, henceforth,         Unimplemented
                                                 regularly monitor the City’s CIP      As of December 31,
                                                 accounts to ensure the timely             2024, the CIP
                                                 transfer of the completed projects   accounts still include
                                                 to the corresponding PPE                projects that were
                                                 accounts.                            physically completed
                                                                                          but were not yet
                                                                                         transferred to the
                                                                                         appropriate PPE
                                                                                       accounts. According
                                                                                        to the personnel of
                                                                                              the CAO,
                                                                                             construction
                                                                                        materials used for
                                                                                          these completed
                                                                                      projects were still not
                                                                                      recorded in the books
                                                                                           due to the non-
                                                                                         submission of the
                                                                                       SSMI by the CGSO.
 2023     2) A           difference         of 4) The CGSO fast-track the                 Unimplemented
 AAR,     ₱21,036,793.98 in the balance of the    submission of the RSI and SSMI       Timely preparation
  AO      CIP account exists between the          to the CAO for the proper           and submission of the
 No. 2,   records maintained by the CAO and       recognition of project expenses.    SSMI by the CGSO to
 page     the City Planning and Development                                              the CAO was not
  37      Office (CPDO), which is not                                                       implemented.
          compliant with IPSAS 1, thereby
          adversely affecting the reliability 5) The City Accountant closely             Unimplemented
          and fairness of presentation of the     coordinate with CGSO and
                                                  CPDO       to    expedite     the



                                                                                                           62
