Meta PixelAnnual Audit Report 2024 — Province of Negros Oriental — Page 66

Page 66 of 161

Page 66

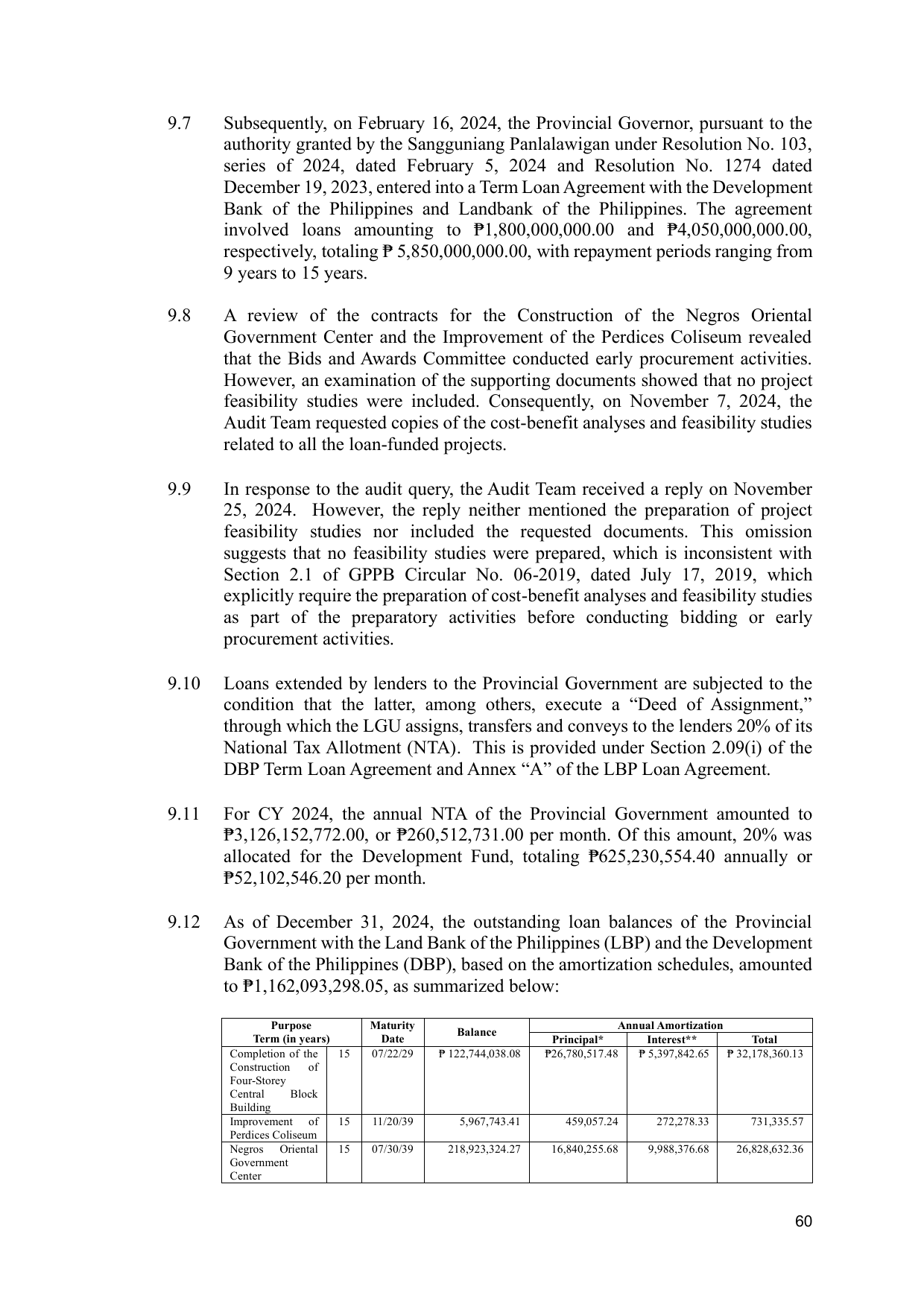

9.7    Subsequently, on February 16, 2024, the Provincial Governor, pursuant to the
       authority granted by the Sangguniang Panlalawigan under Resolution No. 103,
       series of 2024, dated February 5, 2024 and Resolution No. 1274 dated
       December 19, 2023, entered into a Term Loan Agreement with the Development
       Bank of the Philippines and Landbank of the Philippines. The agreement
       involved loans amounting to ₱1,800,000,000.00 and ₱4,050,000,000.00,
       respectively, totaling ₱ 5,850,000,000.00, with repayment periods ranging from
       9 years to 15 years.

9.8    A review of the contracts for the Construction of the Negros Oriental
       Government Center and the Improvement of the Perdices Coliseum revealed
       that the Bids and Awards Committee conducted early procurement activities.
       However, an examination of the supporting documents showed that no project
       feasibility studies were included. Consequently, on November 7, 2024, the
       Audit Team requested copies of the cost-benefit analyses and feasibility studies
       related to all the loan-funded projects.

9.9    In response to the audit query, the Audit Team received a reply on November
       25, 2024. However, the reply neither mentioned the preparation of project
       feasibility studies nor included the requested documents. This omission
       suggests that no feasibility studies were prepared, which is inconsistent with
       Section 2.1 of GPPB Circular No. 06-2019, dated July 17, 2019, which
       explicitly require the preparation of cost-benefit analyses and feasibility studies
       as part of the preparatory activities before conducting bidding or early
       procurement activities.

9.10   Loans extended by lenders to the Provincial Government are subjected to the
       condition that the latter, among others, execute a “Deed of Assignment,”
       through which the LGU assigns, transfers and conveys to the lenders 20% of its
       National Tax Allotment (NTA). This is provided under Section 2.09(i) of the
       DBP Term Loan Agreement and Annex “A” of the LBP Loan Agreement.

9.11   For CY 2024, the annual NTA of the Provincial Government amounted to
       ₱3,126,152,772.00, or ₱260,512,731.00 per month. Of this amount, 20% was
       allocated for the Development Fund, totaling ₱625,230,554.40 annually or
       ₱52,102,546.20 per month.

9.12   As of December 31, 2024, the outstanding loan balances of the Provincial
       Government with the Land Bank of the Philippines (LBP) and the Development
       Bank of the Philippines (DBP), based on the amortization schedules, amounted
       to ₱1,162,093,298.05, as summarized below:

                Purpose          Maturity                                    Annual Amortization
                                               Balance
            Term (in years)        Date                         Principal*        Interest**          Total
       Completion of the    15   07/22/29   ₱ 122,744,038.08   ₱26,780,517.48   ₱ 5,397,842.65   ₱ 32,178,360.13
       Construction    of
       Four-Storey
       Central      Block
       Building
       Improvement of       15   11/20/39       5,967,743.41      459,057.24        272,278.33        731,335.57
       Perdices Coliseum
       Negros Oriental      15   07/30/39    218,923,324.27     16,840,255.68     9,988,376.68     26,828,632.36
       Government
       Center



                                                                                                              60
