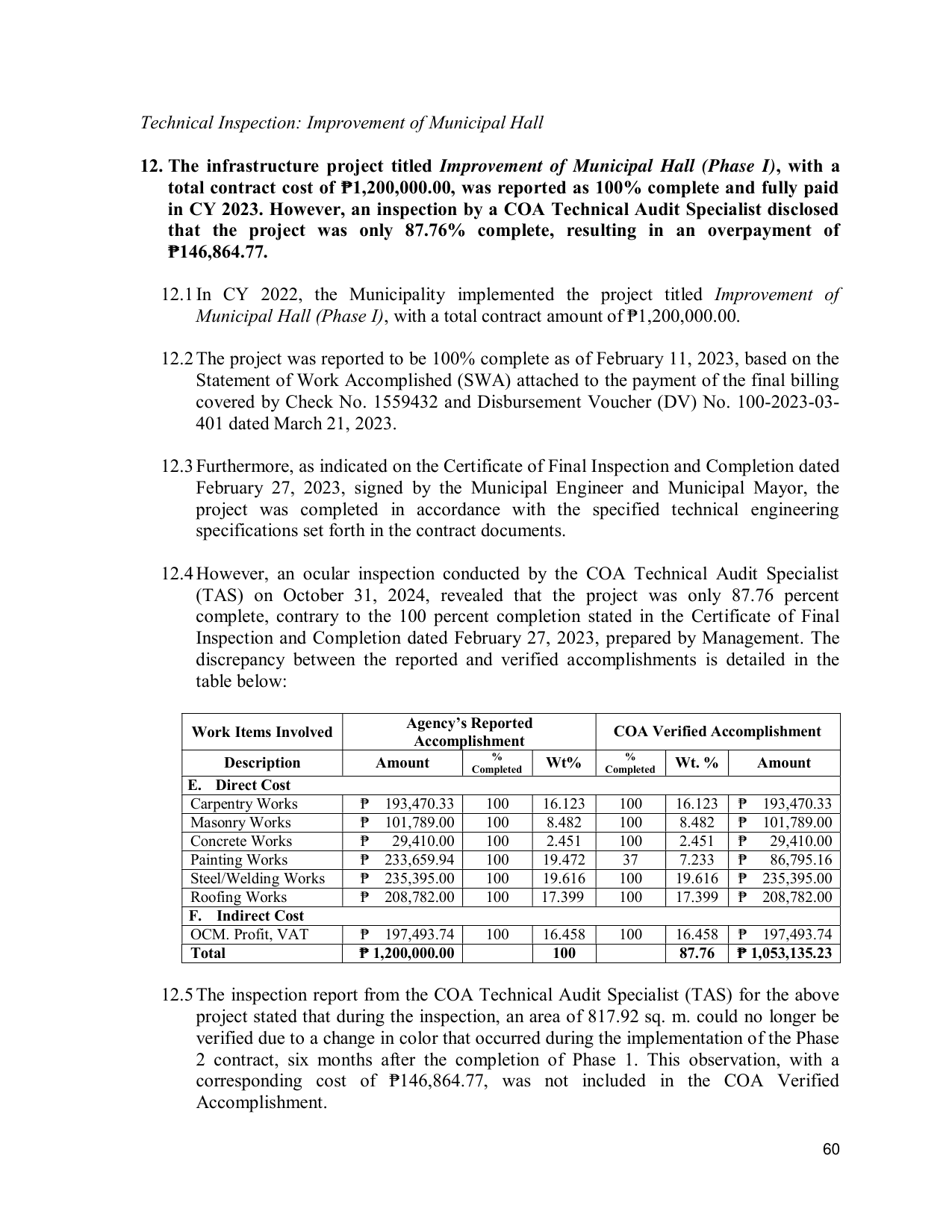

Technical Inspection: Improvement of Municipal Hall

12. The infrastructure project titled Improvement of Municipal Hall (Phase I), with a
    total contract cost of ₱1,200,000.00, was reported as 100% complete and fully paid
    in CY 2023. However, an inspection by a COA Technical Audit Specialist disclosed
    that the project was only 87.76% complete, resulting in an overpayment of
    ₱146,864.77.

  12.1 In CY 2022, the Municipality implemented the project titled Improvement of
       Municipal Hall (Phase I), with a total contract amount of ₱1,200,000.00.

  12.2 The project was reported to be 100% complete as of February 11, 2023, based on the
       Statement of Work Accomplished (SWA) attached to the payment of the final billing
       covered by Check No. 1559432 and Disbursement Voucher (DV) No. 100-2023-03-
       401 dated March 21, 2023.

  12.3 Furthermore, as indicated on the Certificate of Final Inspection and Completion dated
       February 27, 2023, signed by the Municipal Engineer and Municipal Mayor, the
       project was completed in accordance with the specified technical engineering
       specifications set forth in the contract documents.

  12.4 However, an ocular inspection conducted by the COA Technical Audit Specialist
       (TAS) on October 31, 2024, revealed that the project was only 87.76 percent
       complete, contrary to the 100 percent completion stated in the Certificate of Final
       Inspection and Completion dated February 27, 2023, prepared by Management. The
       discrepancy between the reported and verified accomplishments is detailed in the
       table below:

                                   Agency’s Reported
      Work Items Involved                                      COA Verified Accomplishment
                                    Accomplishment
                                               %                 %
           Description          Amount      Completed Wt%     Completed   Wt. %        Amount
     E. Direct Cost
     Carpentry Works        ₱    193,470.33   100   16.123      100       16.123   ₱   193,470.33
     Masonry Works          ₱    101,789.00   100    8.482      100        8.482   ₱   101,789.00
     Concrete Works         ₱     29,410.00   100    2.451      100        2.451   ₱    29,410.00
     Painting Works         ₱    233,659.94   100   19.472      37         7.233   ₱    86,795.16
     Steel/Welding Works    ₱    235,395.00   100   19.616      100       19.616   ₱   235,395.00
     Roofing Works          ₱    208,782.00   100   17.399      100       17.399   ₱   208,782.00
     F. Indirect Cost
     OCM. Profit, VAT       ₱ 197,493.74      100    16.458     100       16.458   ₱ 197,493.74
     Total                  ₱ 1,200,000.00            100                  87.76   ₱ 1,053,135.23

  12.5 The inspection report from the COA Technical Audit Specialist (TAS) for the above
       project stated that during the inspection, an area of 817.92 sq. m. could no longer be
       verified due to a change in color that occurred during the implementation of the Phase
       2 contract, six months after the completion of Phase 1. This observation, with a
       corresponding cost of ₱146,864.77, was not included in the COA Verified
       Accomplishment.

                                                                                                60
