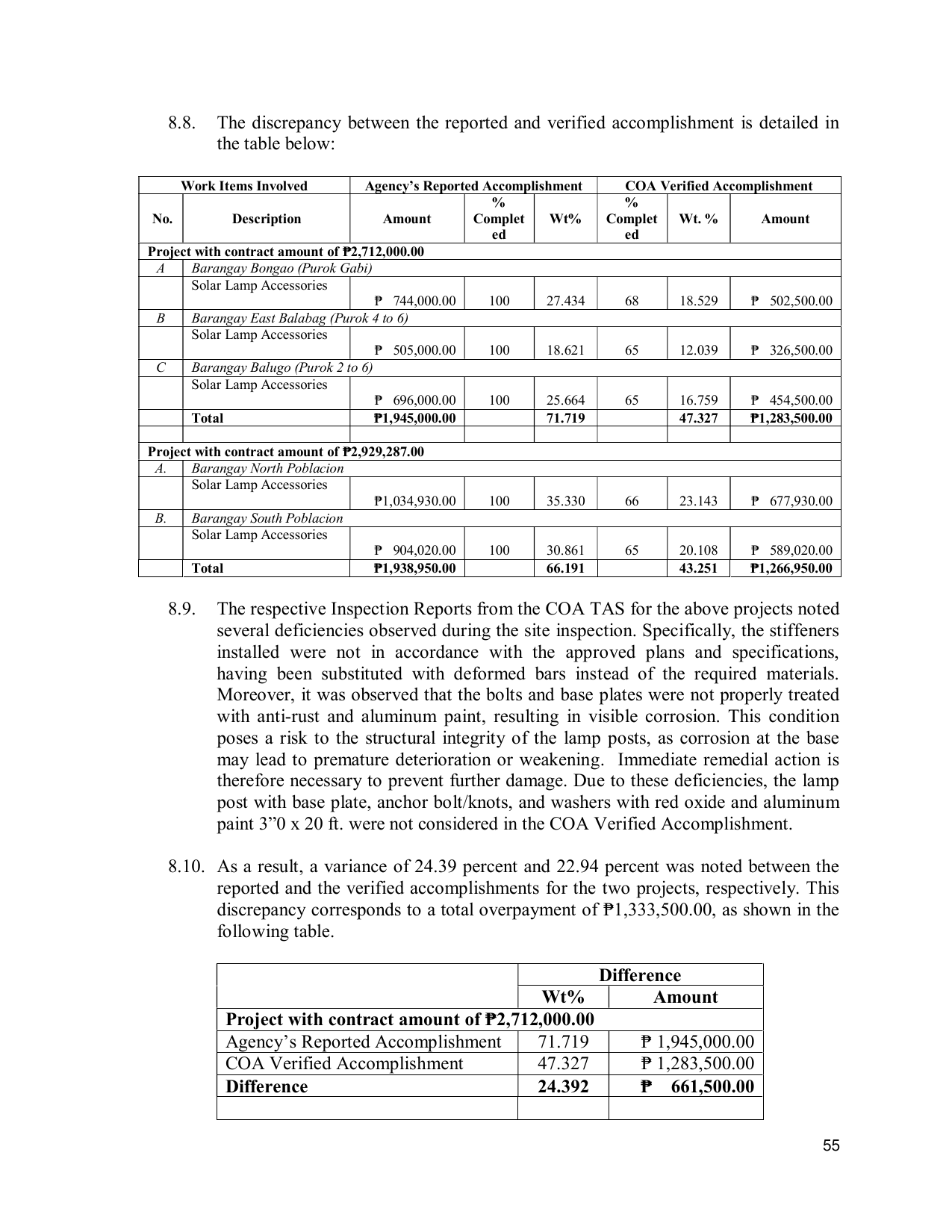

   8.8.    The discrepancy between the reported and verified accomplishment is detailed in
           the table below:

     Work Items Involved           Agency’s Reported Accomplishment      COA Verified Accomplishment
                                                      %                  %
 No.          Description              Amount       Complet    Wt%     Complet Wt. %        Amount
                                                      ed                 ed
Project with contract amount of ₱2,712,000.00
 A     Barangay Bongao (Purok Gabi)
       Solar Lamp Accessories
                                      ₱ 744,000.00    100     27.434     68      18.529    ₱ 502,500.00
 B     Barangay East Balabag (Purok 4 to 6)
       Solar Lamp Accessories
                                      ₱ 505,000.00    100     18.621     65      12.039    ₱ 326,500.00
 C     Barangay Balugo (Purok 2 to 6)
       Solar Lamp Accessories
                                      ₱ 696,000.00    100     25.664     65      16.759    ₱ 454,500.00
       Total                          ₱1,945,000.00           71.719             47.327    ₱1,283,500.00

Project with contract amount of ₱2,929,287.00
 A.    Barangay North Poblacion
       Solar Lamp Accessories
                                     ₱1,034,930.00   100     35.330      66      23.143    ₱ 677,930.00
 B.    Barangay South Poblacion
       Solar Lamp Accessories
                                     ₱ 904,020.00    100     30.861      65      20.108    ₱ 589,020.00
       Total                         ₱1,938,950.00           66.191              43.251    ₱1,266,950.00

   8.9.    The respective Inspection Reports from the COA TAS for the above projects noted
           several deficiencies observed during the site inspection. Specifically, the stiffeners
           installed were not in accordance with the approved plans and specifications,
           having been substituted with deformed bars instead of the required materials.
           Moreover, it was observed that the bolts and base plates were not properly treated
           with anti-rust and aluminum paint, resulting in visible corrosion. This condition
           poses a risk to the structural integrity of the lamp posts, as corrosion at the base
           may lead to premature deterioration or weakening. Immediate remedial action is
           therefore necessary to prevent further damage. Due to these deficiencies, the lamp
           post with base plate, anchor bolt/knots, and washers with red oxide and aluminum
           paint 3”0 x 20 ft. were not considered in the COA Verified Accomplishment.

   8.10. As a result, a variance of 24.39 percent and 22.94 percent was noted between the
         reported and the verified accomplishments for the two projects, respectively. This
         discrepancy corresponds to a total overpayment of ₱1,333,500.00, as shown in the
         following table.

                                                          Difference
                                                   Wt%           Amount
            Project with contract amount of ₱2,712,000.00
            Agency’s Reported Accomplishment      71.719       ₱ 1,945,000.00
            COA Verified Accomplishment           47.327       ₱ 1,283,500.00
            Difference                            24.392       ₱ 661,500.00


                                                                                                       55
