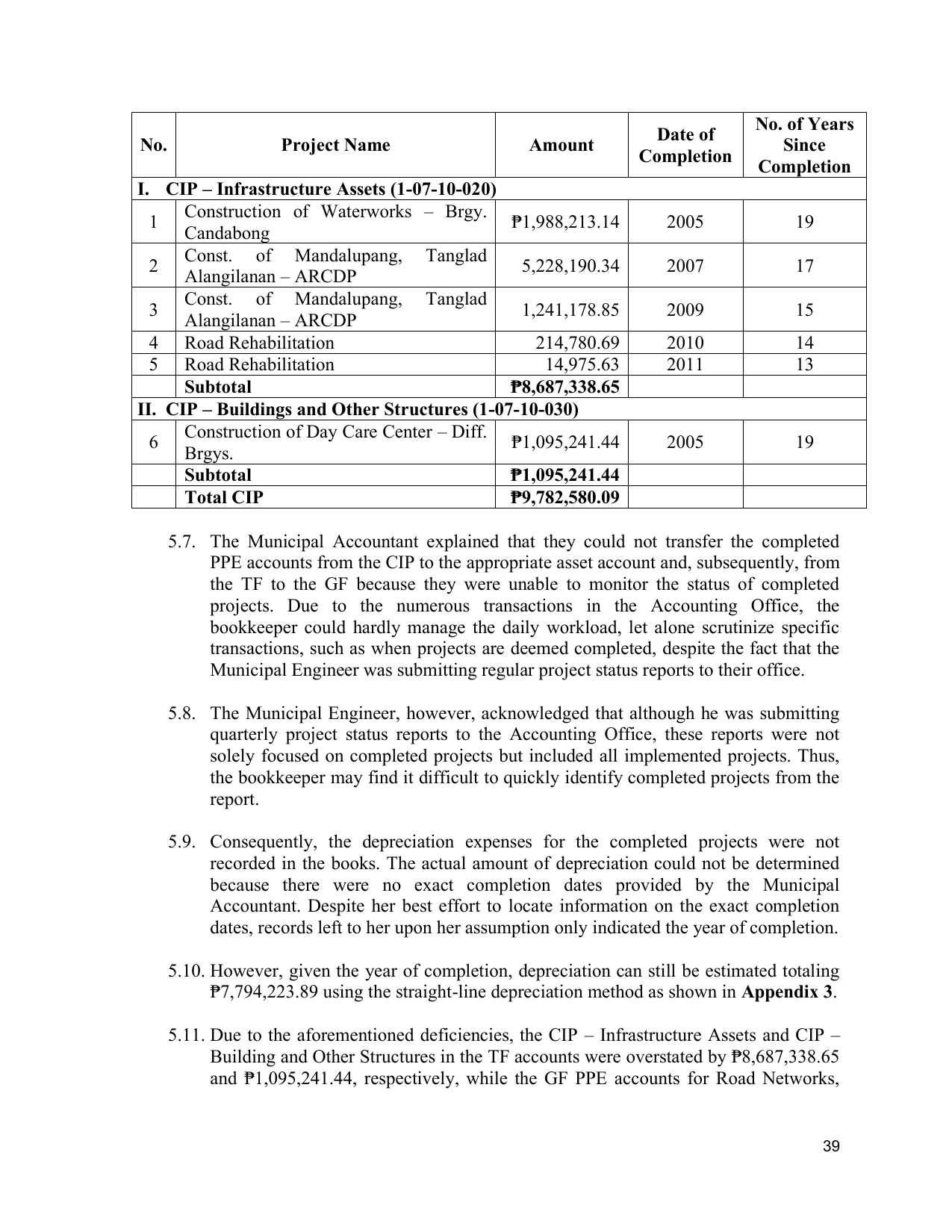

                                                                                    No. of Years
                                                                      Date of
No.                  Project Name                     Amount                           Since
                                                                     Completion
                                                                                    Completion
I. CIP – Infrastructure Assets (1-07-10-020)
      Construction of Waterworks – Brgy.
  1                                           ₱1,988,213.14             2005              19
      Candabong
      Const. of Mandalupang, Tanglad
  2                                            5,228,190.34             2007              17
      Alangilanan – ARCDP
      Const. of Mandalupang, Tanglad
  3                                            1,241,178.85             2009              15
      Alangilanan – ARCDP
  4 Road Rehabilitation                          214,780.69             2010              14
  5 Road Rehabilitation                           14,975.63             2011              13
      Subtotal                                ₱8,687,338.65
II. CIP – Buildings and Other Structures (1-07-10-030)
      Construction of Day Care Center – Diff.
  6                                           ₱1,095,241.44             2005              19
      Brgys.
      Subtotal                                ₱1,095,241.44
      Total CIP                               ₱9,782,580.09

      5.7. The Municipal Accountant explained that they could not transfer the completed
           PPE accounts from the CIP to the appropriate asset account and, subsequently, from
           the TF to the GF because they were unable to monitor the status of completed
           projects. Due to the numerous transactions in the Accounting Office, the
           bookkeeper could hardly manage the daily workload, let alone scrutinize specific
           transactions, such as when projects are deemed completed, despite the fact that the
           Municipal Engineer was submitting regular project status reports to their office.

      5.8. The Municipal Engineer, however, acknowledged that although he was submitting
           quarterly project status reports to the Accounting Office, these reports were not
           solely focused on completed projects but included all implemented projects. Thus,
           the bookkeeper may find it difficult to quickly identify completed projects from the
           report.

      5.9. Consequently, the depreciation expenses for the completed projects were not
           recorded in the books. The actual amount of depreciation could not be determined
           because there were no exact completion dates provided by the Municipal
           Accountant. Despite her best effort to locate information on the exact completion
           dates, records left to her upon her assumption only indicated the year of completion.

      5.10. However, given the year of completion, depreciation can still be estimated totaling
            ₱7,794,223.89 using the straight-line depreciation method as shown in Appendix 3.

      5.11. Due to the aforementioned deficiencies, the CIP – Infrastructure Assets and CIP –
            Building and Other Structures in the TF accounts were overstated by ₱8,687,338.65
            and ₱1,095,241.44, respectively, while the GF PPE accounts for Road Networks,


                                                                                               39
