Meta PixelAnnual Audit Report 2024 — City of Guihulngan — Page 64

Page 64 of 100

Page 64

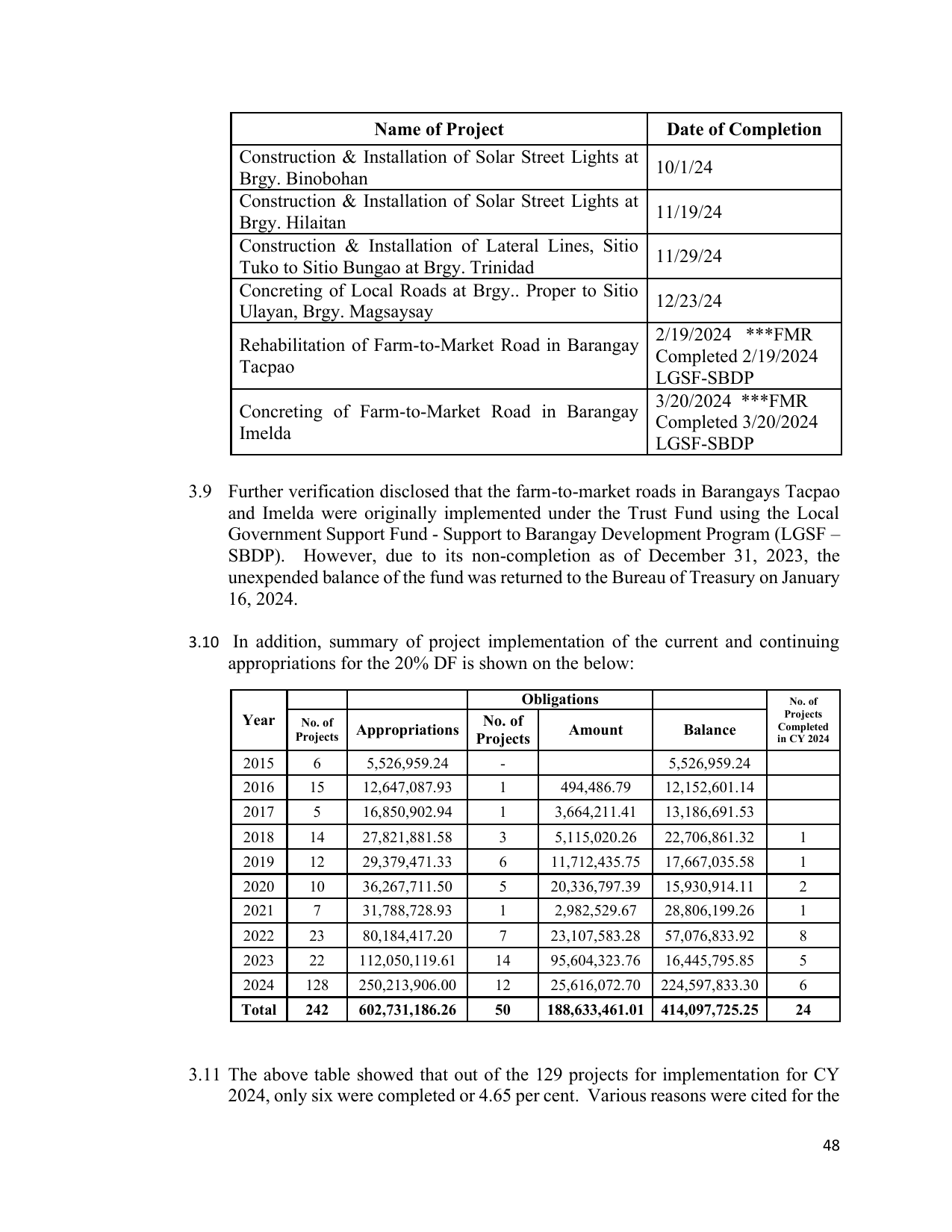

                       Name of Project                                Date of Completion
      Construction & Installation of Solar Street Lights at
                                                                     10/1/24
      Brgy. Binobohan
      Construction & Installation of Solar Street Lights at
                                                                     11/19/24
      Brgy. Hilaitan
      Construction & Installation of Lateral Lines, Sitio
                                                                     11/29/24
      Tuko to Sitio Bungao at Brgy. Trinidad
      Concreting of Local Roads at Brgy.. Proper to Sitio
                                                                     12/23/24
      Ulayan, Brgy. Magsaysay
                                                        2/19/2024 ***FMR
      Rehabilitation of Farm-to-Market Road in Barangay
                                                        Completed 2/19/2024
      Tacpao
                                                        LGSF-SBDP
                                                        3/20/2024 ***FMR
      Concreting of Farm-to-Market Road in Barangay
                                                        Completed 3/20/2024
      Imelda
                                                        LGSF-SBDP

3.9 Further verification disclosed that the farm-to-market roads in Barangays Tacpao
    and Imelda were originally implemented under the Trust Fund using the Local
    Government Support Fund - Support to Barangay Development Program (LGSF –
    SBDP). However, due to its non-completion as of December 31, 2023, the
    unexpended balance of the fund was returned to the Bureau of Treasury on January
    16, 2024.

3.10 In addition, summary of project implementation of the current and continuing
     appropriations for the 20% DF is shown on the below:
                                                  Obligations                            No. of
                                                                                        Projects
       Year     No. of                      No. of                                    Completed
               Projects   Appropriations                Amount          Balance
                                           Projects                                   in CY 2024

       2015       6        5,526,959.24       -                       5,526,959.24
       2016      15       12,647,087.93       1      494,486.79       12,152,601.14
       2017       5       16,850,902.94       1      3,664,211.41     13,186,691.53
       2018      14       27,821,881.58       3      5,115,020.26     22,706,861.32       1
       2019      12       29,379,471.33       6     11,712,435.75     17,667,035.58       1
       2020      10       36,267,711.50       5     20,336,797.39     15,930,914.11       2
       2021       7       31,788,728.93       1      2,982,529.67     28,806,199.26       1
       2022      23       80,184,417.20       7     23,107,583.28     57,076,833.92       8
       2023      22       112,050,119.61     14     95,604,323.76     16,445,795.85       5
       2024     128       250,213,906.00     12     25,616,072.70    224,597,833.30       6
       Total    242       602,731,186.26     50     188,633,461.01   414,097,725.25      24



3.11 The above table showed that out of the 129 projects for implementation for CY
     2024, only six were completed or 4.65 per cent. Various reasons were cited for the

                                                                                              48
