Meta PixelAnnual Audit Report 2024 — City of Dumaguete — Page 37

Page 37 of 89

Page 37

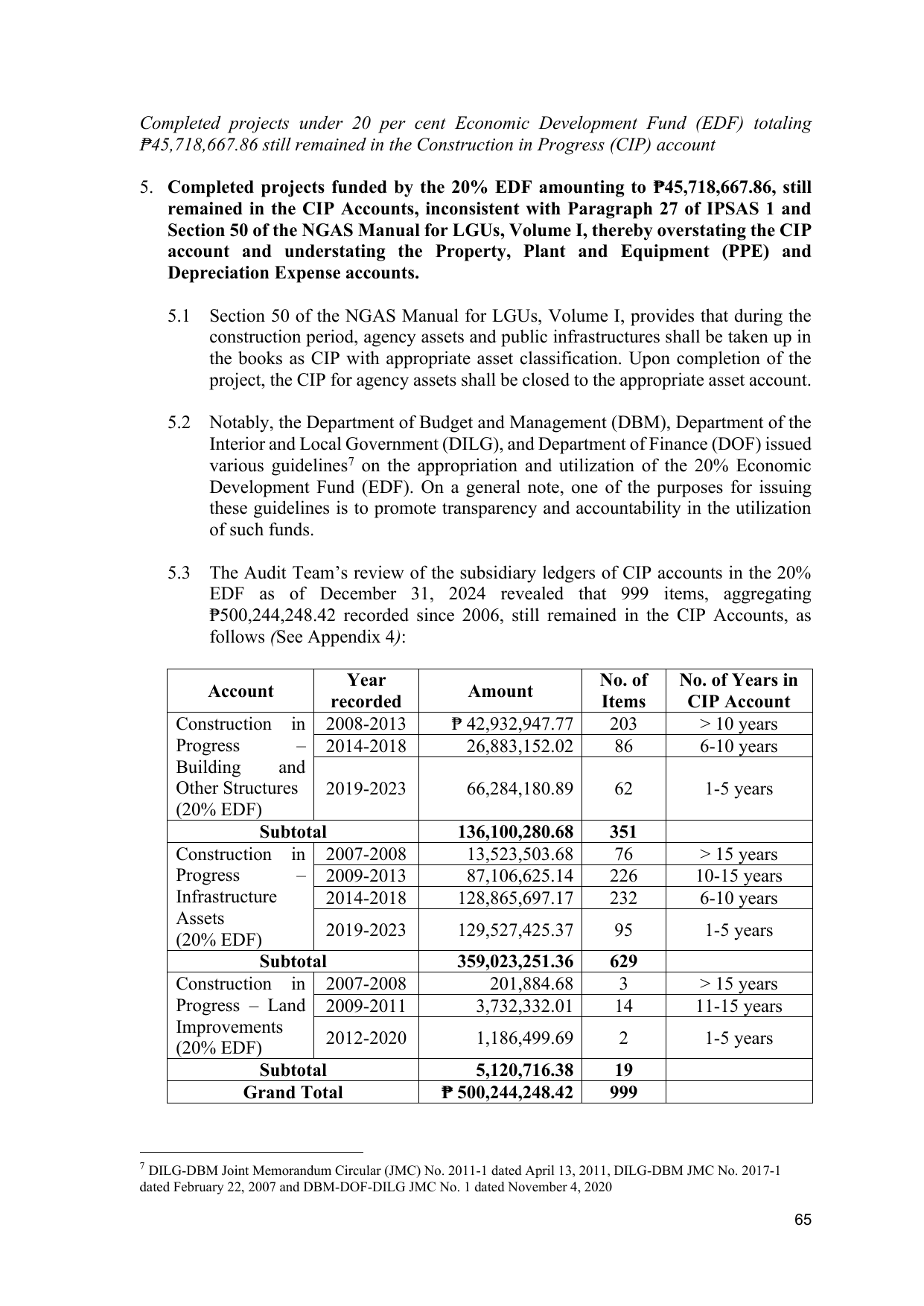

Completed projects under 20 per cent Economic Development Fund (EDF) totaling
₱45,718,667.86 still remained in the Construction in Progress (CIP) account

5. Completed projects funded by the 20% EDF amounting to ₱45,718,667.86, still
   remained in the CIP Accounts, inconsistent with Paragraph 27 of IPSAS 1 and
   Section 50 of the NGAS Manual for LGUs, Volume I, thereby overstating the CIP
   account and understating the Property, Plant and Equipment (PPE) and
   Depreciation Expense accounts.

    5.1   Section 50 of the NGAS Manual for LGUs, Volume I, provides that during the
          construction period, agency assets and public infrastructures shall be taken up in
          the books as CIP with appropriate asset classification. Upon completion of the
          project, the CIP for agency assets shall be closed to the appropriate asset account.

    5.2   Notably, the Department of Budget and Management (DBM), Department of the
          Interior and Local Government (DILG), and Department of Finance (DOF) issued
          various guidelines7 on the appropriation and utilization of the 20% Economic
          Development Fund (EDF). On a general note, one of the purposes for issuing
          these guidelines is to promote transparency and accountability in the utilization
          of such funds.

    5.3   The Audit Team’s review of the subsidiary ledgers of CIP accounts in the 20%
          EDF as of December 31, 2024 revealed that 999 items, aggregating
          ₱500,244,248.42 recorded since 2006, still remained in the CIP Accounts, as
          follows (See Appendix 4):

                               Year                                   No. of      No. of Years in
          Account                                 Amount
                             recorded                                 Items        CIP Account
     Construction in        2008-2013          ₱ 42,932,947.77         203          > 10 years
     Progress         –     2014-2018            26,883,152.02          86          6-10 years
     Building       and
     Other Structures 2019-2023                  66,284,180.89          62            1-5 years
     (20% EDF)
                 Subtotal                       136,100,280.68         351
     Construction in 2007-2008                   13,523,503.68          76           > 15 years
     Progress         – 2009-2013                87,106,625.14         226          10-15 years
     Infrastructure      2014-2018              128,865,697.17         232          6-10 years
     Assets
                         2019-2023              129,527,425.37          95            1-5 years
     (20% EDF)
                 Subtotal                       359,023,251.36         629
     Construction in 2007-2008                      201,884.68           3           > 15 years
     Progress – Land 2009-2011                    3,732,332.01          14          11-15 years
     Improvements
                         2012-2020                 1,186,499.69          2            1-5 years
     (20% EDF)
                 Subtotal                         5,120,716.38          19
              Grand Total                     ₱ 500,244,248.42         999


7
 DILG-DBM Joint Memorandum Circular (JMC) No. 2011-1 dated April 13, 2011, DILG-DBM JMC No. 2017-1
dated February 22, 2007 and DBM-DOF-DILG JMC No. 1 dated November 4, 2020

                                                                                                     65
