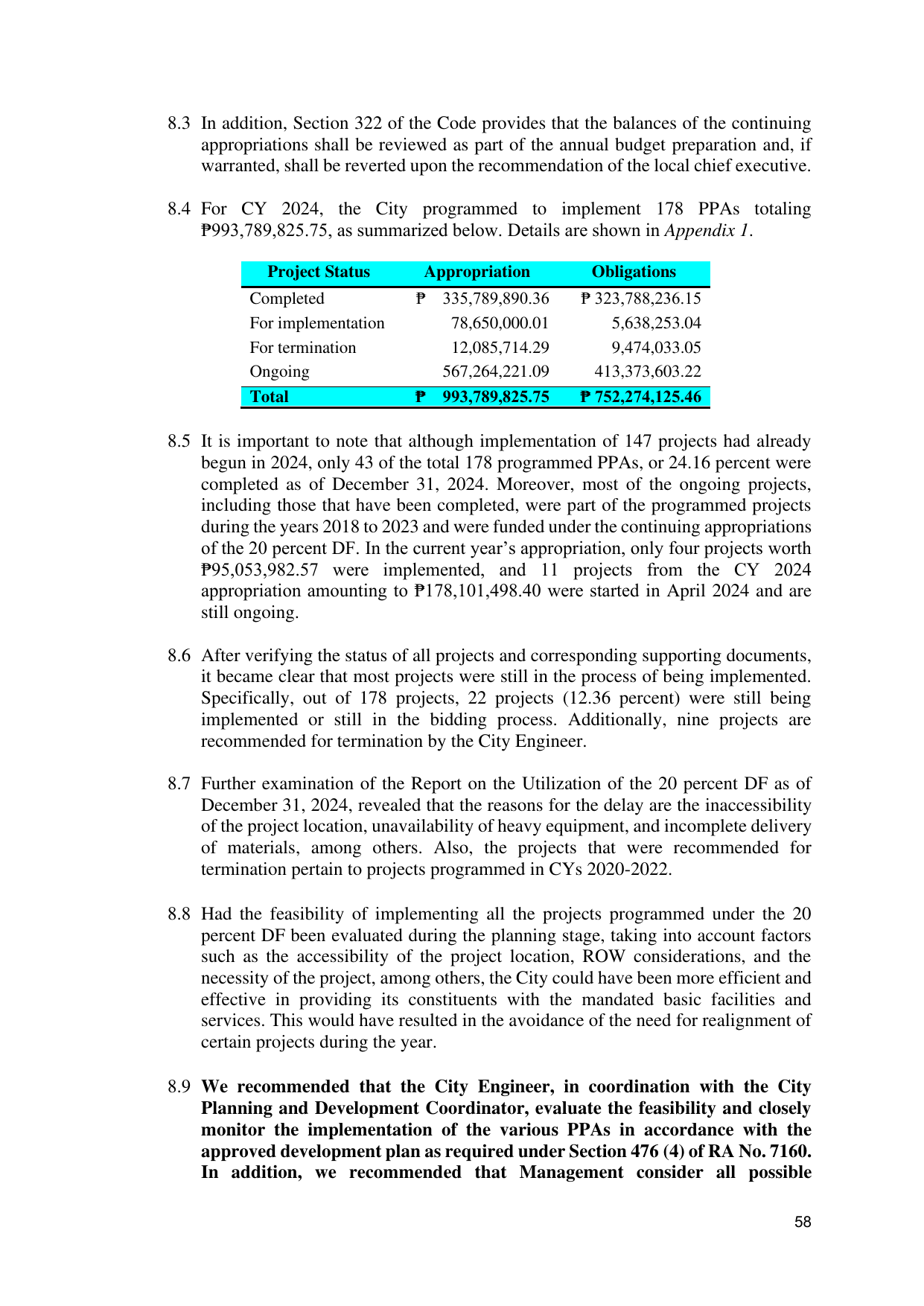

8.3 In addition, Section 322 of the Code provides that the balances of the continuing
    appropriations shall be reviewed as part of the annual budget preparation and, if
    warranted, shall be reverted upon the recommendation of the local chief executive.

8.4 For CY 2024, the City programmed to implement 178 PPAs totaling
    ₱993,789,825.75, as summarized below. Details are shown in Appendix 1.

             Project Status       Appropriation          Obligations
           Completed             ₱ 335,789,890.36      ₱ 323,788,236.15
           For implementation       78,650,000.01          5,638,253.04
           For termination          12,085,714.29          9,474,033.05
           Ongoing                 567,264,221.09        413,373,603.22
           Total                 ₱ 993,789,825.75      ₱ 752,274,125.46

8.5 It is important to note that although implementation of 147 projects had already
    begun in 2024, only 43 of the total 178 programmed PPAs, or 24.16 percent were
    completed as of December 31, 2024. Moreover, most of the ongoing projects,
    including those that have been completed, were part of the programmed projects
    during the years 2018 to 2023 and were funded under the continuing appropriations
    of the 20 percent DF. In the current year’s appropriation, only four projects worth
    ₱95,053,982.57 were implemented, and 11 projects from the CY 2024
    appropriation amounting to ₱178,101,498.40 were started in April 2024 and are
    still ongoing.

8.6 After verifying the status of all projects and corresponding supporting documents,
    it became clear that most projects were still in the process of being implemented.
    Specifically, out of 178 projects, 22 projects (12.36 percent) were still being
    implemented or still in the bidding process. Additionally, nine projects are
    recommended for termination by the City Engineer.

8.7 Further examination of the Report on the Utilization of the 20 percent DF as of
    December 31, 2024, revealed that the reasons for the delay are the inaccessibility
    of the project location, unavailability of heavy equipment, and incomplete delivery
    of materials, among others. Also, the projects that were recommended for
    termination pertain to projects programmed in CYs 2020-2022.

8.8 Had the feasibility of implementing all the projects programmed under the 20
    percent DF been evaluated during the planning stage, taking into account factors
    such as the accessibility of the project location, ROW considerations, and the
    necessity of the project, among others, the City could have been more efficient and
    effective in providing its constituents with the mandated basic facilities and
    services. This would have resulted in the avoidance of the need for realignment of
    certain projects during the year.

8.9 We recommended that the City Engineer, in coordination with the City
    Planning and Development Coordinator, evaluate the feasibility and closely
    monitor the implementation of the various PPAs in accordance with the
    approved development plan as required under Section 476 (4) of RA No. 7160.
    In addition, we recommended that Management consider all possible
