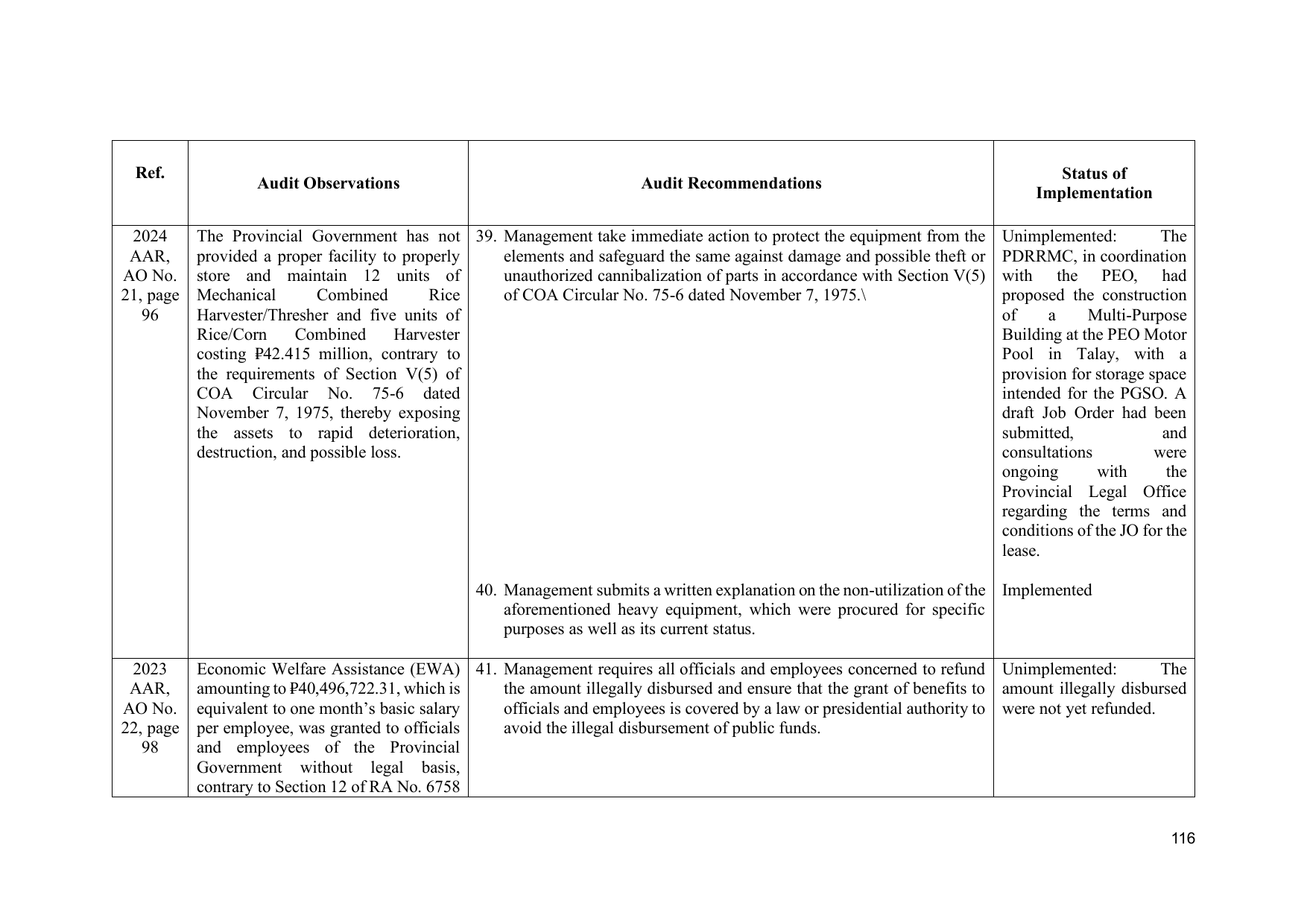

Ref. Status of
Audit Observations Audit Recommendations
Implementation
2024 The Provincial Government has not 39. Management take immediate action to protect the equipment from the Unimplemented: The
AAR, provided a proper facility to properly elements and safeguard the same against damage and possible theft or PDRRMC, in coordination
AO No. store and maintain 12 units of unauthorized cannibalization of parts in accordance with Section V(5) with the PEO, had
21, page Mechanical Combined Rice of COA Circular No. 75-6 dated November 7, 1975.\ proposed the construction
96 Harvester/Thresher and five units of of a Multi-Purpose
Rice/Corn Combined Harvester Building at the PEO Motor
costing ₽42.415 million, contrary to Pool in Talay, with a
the requirements of Section V(5) of provision for storage space
COA Circular No. 75-6 dated intended for the PGSO. A
November 7, 1975, thereby exposing draft Job Order had been
the assets to rapid deterioration, submitted, and
destruction, and possible loss. consultations were
ongoing with the
Provincial Legal Office
regarding the terms and
conditions of the JO for the
lease.
40. Management submits a written explanation on the non-utilization of the Implemented
aforementioned heavy equipment, which were procured for specific
purposes as well as its current status.
2023 Economic Welfare Assistance (EWA) 41. Management requires all officials and employees concerned to refund Unimplemented: The
AAR, amounting to ₽40,496,722.31, which is the amount illegally disbursed and ensure that the grant of benefits to amount illegally disbursed
AO No. equivalent to one month’s basic salary officials and employees is covered by a law or presidential authority to were not yet refunded.
22, page per employee, was granted to officials avoid the illegal disbursement of public funds.
98 and employees of the Provincial
Government without legal basis,
contrary to Section 12 of RA No. 6758
