Meta PixelAnnual Audit Report 2024 — Municipality of Pamplona — Page 56

Page 56 of 124

Page 56

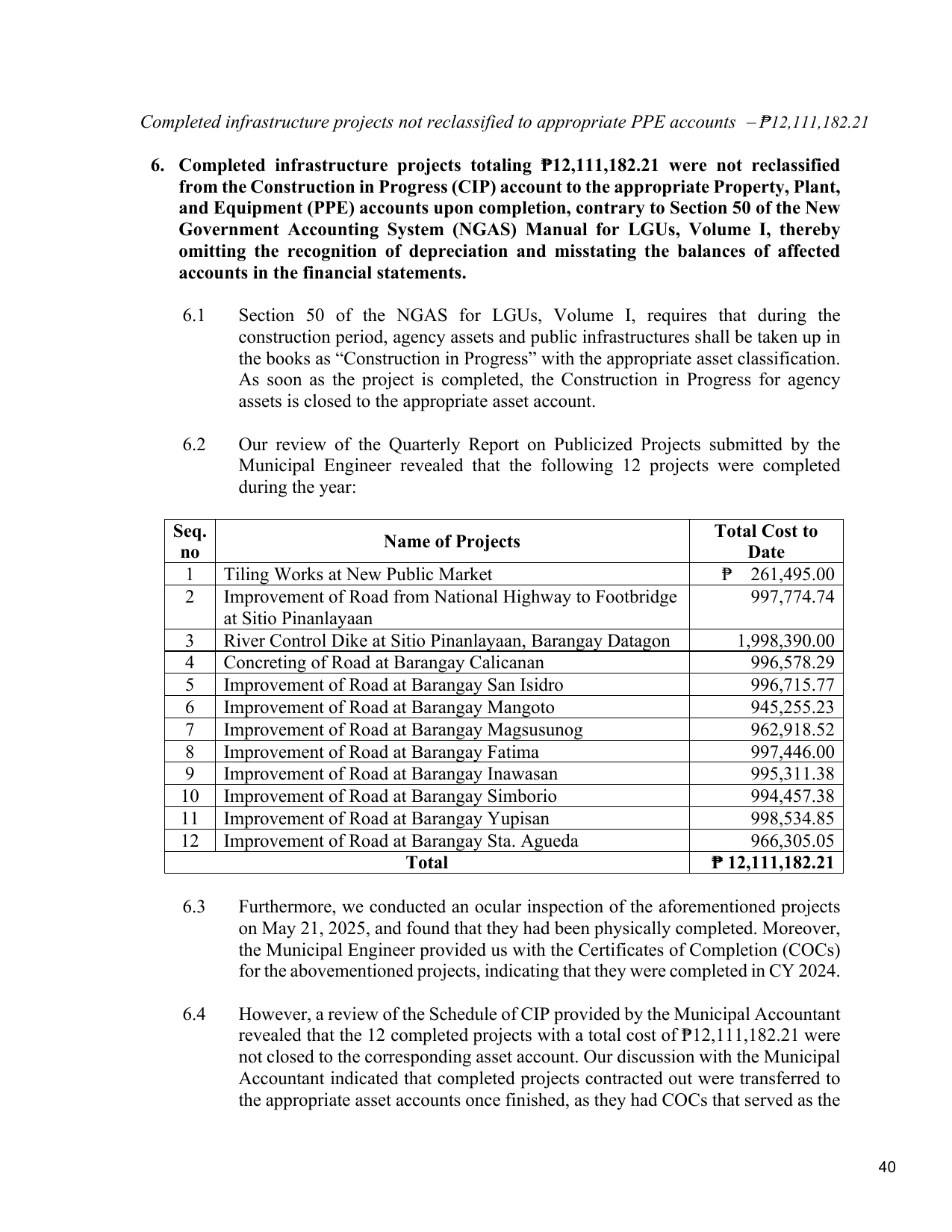

Completed infrastructure projects not reclassified to appropriate PPE accounts – ₱12,111,182.21

 6. Completed infrastructure projects totaling ₱12,111,182.21 were not reclassified
    from the Construction in Progress (CIP) account to the appropriate Property, Plant,
    and Equipment (PPE) accounts upon completion, contrary to Section 50 of the New
    Government Accounting System (NGAS) Manual for LGUs, Volume I, thereby
    omitting the recognition of depreciation and misstating the balances of affected
    accounts in the financial statements.

     6.1    Section 50 of the NGAS for LGUs, Volume I, requires that during the
            construction period, agency assets and public infrastructures shall be taken up in
            the books as “Construction in Progress” with the appropriate asset classification.
            As soon as the project is completed, the Construction in Progress for agency
            assets is closed to the appropriate asset account.

     6.2    Our review of the Quarterly Report on Publicized Projects submitted by the
            Municipal Engineer revealed that the following 12 projects were completed
            during the year:

    Seq.                                                                    Total Cost to
                              Name of Projects
     no                                                                         Date
      1  Tiling Works at New Public Market                                   ₱ 261,495.00
      2  Improvement of Road from National Highway to Footbridge                997,774.74
         at Sitio Pinanlayaan
      3  River Control Dike at Sitio Pinanlayaan, Barangay Datagon             1,998,390.00
      4  Concreting of Road at Barangay Calicanan                                996,578.29
      5  Improvement of Road at Barangay San Isidro                              996,715.77
      6  Improvement of Road at Barangay Mangoto                                 945,255.23
      7  Improvement of Road at Barangay Magsusunog                              962,918.52
      8  Improvement of Road at Barangay Fatima                                  997,446.00
      9  Improvement of Road at Barangay Inawasan                                995,311.38
     10 Improvement of Road at Barangay Simborio                                 994,457.38
     11 Improvement of Road at Barangay Yupisan                                  998,534.85
     12 Improvement of Road at Barangay Sta. Agueda                              966,305.05
                                 Total                                      ₱ 12,111,182.21

     6.3    Furthermore, we conducted an ocular inspection of the aforementioned projects
            on May 21, 2025, and found that they had been physically completed. Moreover,
            the Municipal Engineer provided us with the Certificates of Completion (COCs)
            for the abovementioned projects, indicating that they were completed in CY 2024.

     6.4    However, a review of the Schedule of CIP provided by the Municipal Accountant
            revealed that the 12 completed projects with a total cost of ₱12,111,182.21 were
            not closed to the corresponding asset account. Our discussion with the Municipal
            Accountant indicated that completed projects contracted out were transferred to
            the appropriate asset accounts once finished, as they had COCs that served as the


                                                                                                  40
