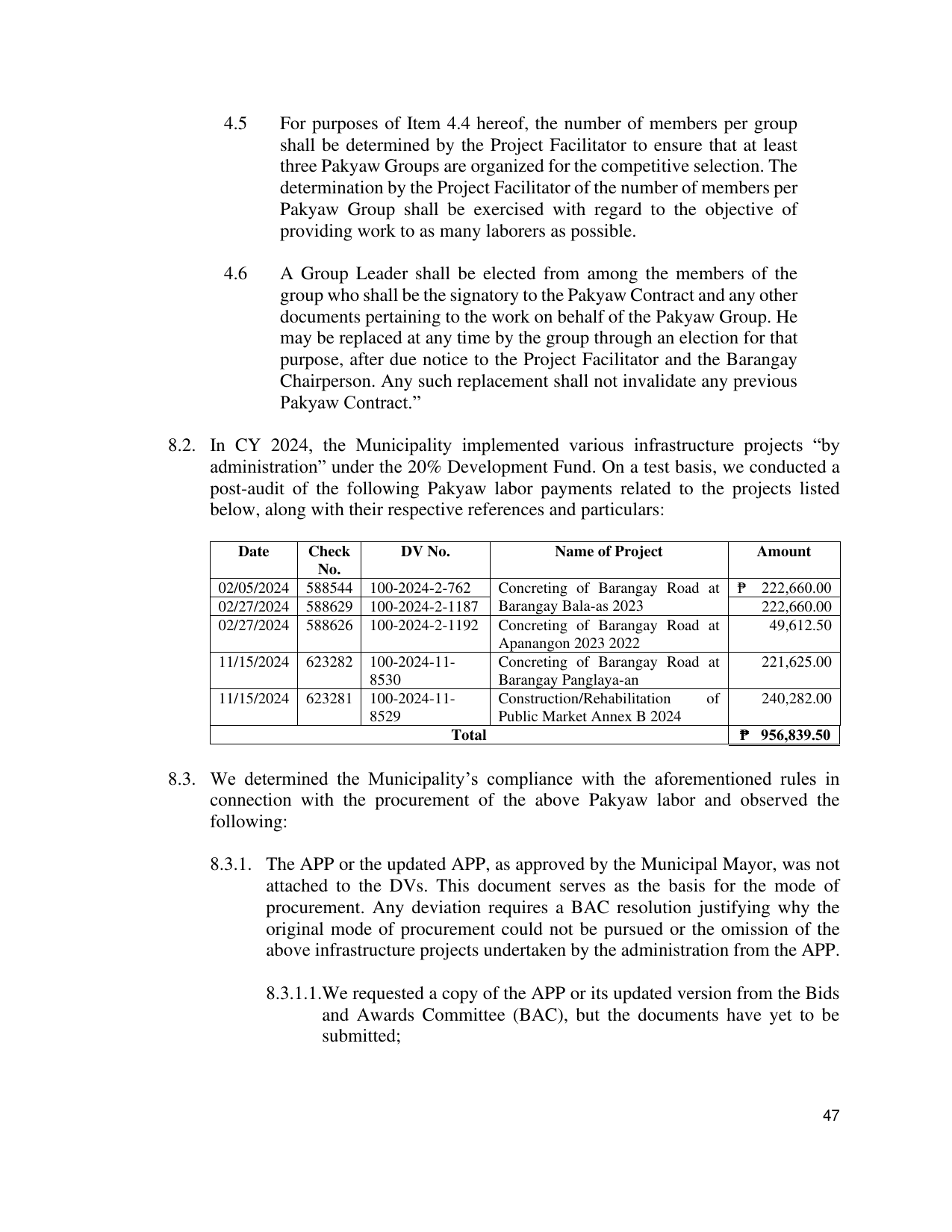

Meta PixelAnnual Audit Report 2024 — Municipality of Jimalalud — Page 61

Page 61 of 101

Page 61
       4.5     For purposes of Item 4.4 hereof, the number of members per group
               shall be determined by the Project Facilitator to ensure that at least
               three Pakyaw Groups are organized for the competitive selection. The
               determination by the Project Facilitator of the number of members per
               Pakyaw Group shall be exercised with regard to the objective of
               providing work to as many laborers as possible.

       4.6     A Group Leader shall be elected from among the members of the
               group who shall be the signatory to the Pakyaw Contract and any other
               documents pertaining to the work on behalf of the Pakyaw Group. He
               may be replaced at any time by the group through an election for that
               purpose, after due notice to the Project Facilitator and the Barangay
               Chairperson. Any such replacement shall not invalidate any previous
               Pakyaw Contract.”

8.2. In CY 2024, the Municipality implemented various infrastructure projects “by
     administration” under the 20% Development Fund. On a test basis, we conducted a
     post-audit of the following Pakyaw labor payments related to the projects listed
     below, along with their respective references and particulars:

        Date       Check        DV No.                Name of Project               Amount
                     No.
      02/05/2024   588544   100-2024-2-762     Concreting of Barangay Road at   ₱   222,660.00
      02/27/2024   588629   100-2024-2-1187    Barangay Bala-as 2023                222,660.00
      02/27/2024   588626   100-2024-2-1192    Concreting of Barangay Road at        49,612.50
                                               Apanangon 2023 2022
      11/15/2024   623282   100-2024-11-       Concreting of Barangay Road at       221,625.00
                            8530               Barangay Panglaya-an
      11/15/2024   623281   100-2024-11-       Construction/Rehabilitation of       240,282.00
                            8529               Public Market Annex B 2024
                                       Total                                    ₱ 956,839.50

8.3. We determined the Municipality’s compliance with the aforementioned rules in
     connection with the procurement of the above Pakyaw labor and observed the
     following:

     8.3.1. The APP or the updated APP, as approved by the Municipal Mayor, was not
            attached to the DVs. This document serves as the basis for the mode of
            procurement. Any deviation requires a BAC resolution justifying why the
            original mode of procurement could not be pursued or the omission of the
            above infrastructure projects undertaken by the administration from the APP.

             8.3.1.1.We requested a copy of the APP or its updated version from the Bids
                     and Awards Committee (BAC), but the documents have yet to be
                     submitted;



                                                                                             47
