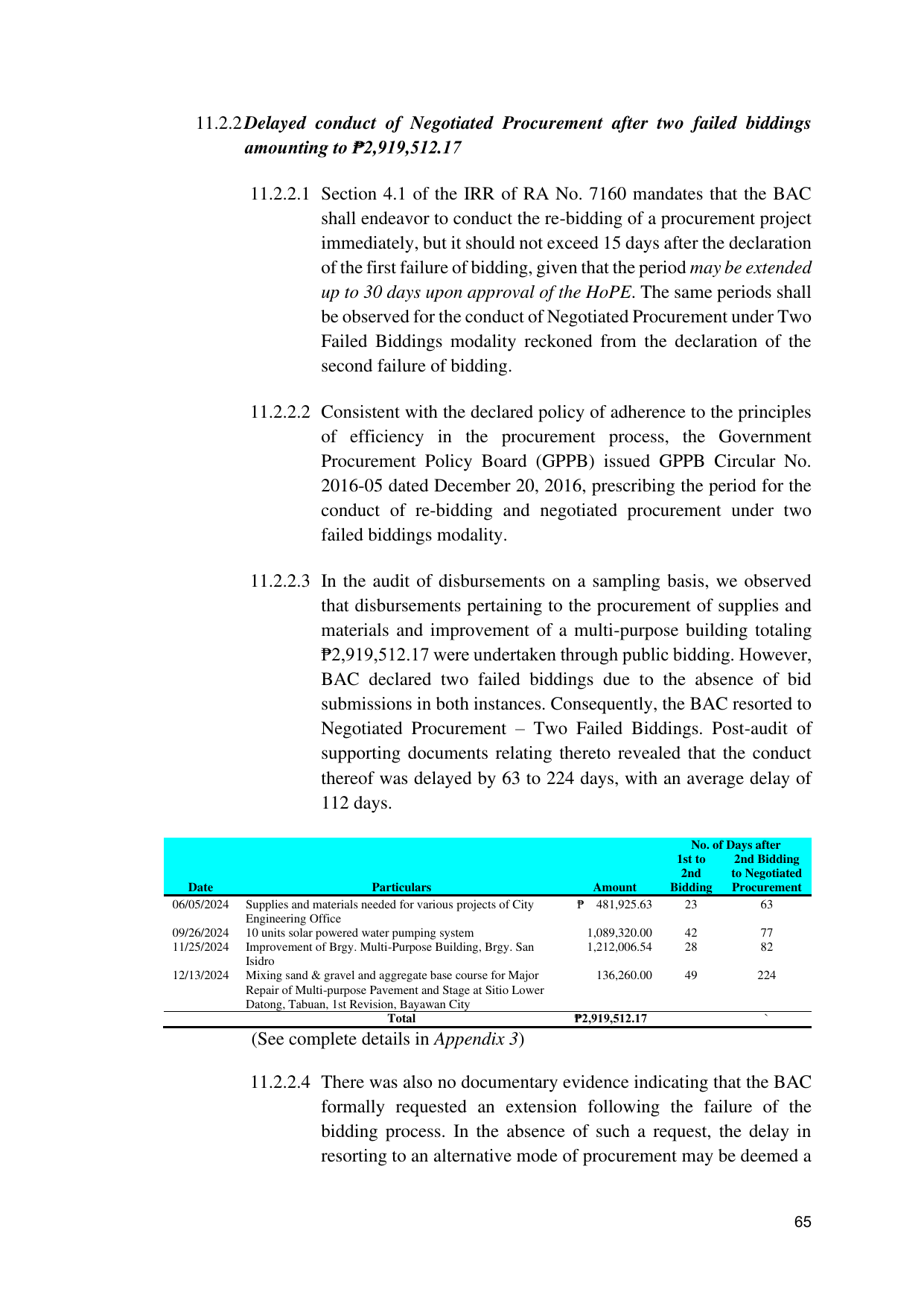

    11.2.2 Delayed conduct of Negotiated Procurement after two failed biddings
           amounting to ₱2,919,512.17

             11.2.2.1 Section 4.1 of the IRR of RA No. 7160 mandates that the BAC
                      shall endeavor to conduct the re-bidding of a procurement project
                      immediately, but it should not exceed 15 days after the declaration
                      of the first failure of bidding, given that the period may be extended
                      up to 30 days upon approval of the HoPE. The same periods shall
                      be observed for the conduct of Negotiated Procurement under Two
                      Failed Biddings modality reckoned from the declaration of the
                      second failure of bidding.

             11.2.2.2 Consistent with the declared policy of adherence to the principles
                      of efficiency in the procurement process, the Government
                      Procurement Policy Board (GPPB) issued GPPB Circular No.
                      2016-05 dated December 20, 2016, prescribing the period for the
                      conduct of re-bidding and negotiated procurement under two
                      failed biddings modality.

             11.2.2.3 In the audit of disbursements on a sampling basis, we observed
                      that disbursements pertaining to the procurement of supplies and
                      materials and improvement of a multi-purpose building totaling
                      ₱2,919,512.17 were undertaken through public bidding. However,
                      BAC declared two failed biddings due to the absence of bid
                      submissions in both instances. Consequently, the BAC resorted to
                      Negotiated Procurement – Two Failed Biddings. Post-audit of
                      supporting documents relating thereto revealed that the conduct
                      thereof was delayed by 63 to 224 days, with an average delay of
                      112 days.

                                                                                               No. of Days after
                                                                                            1st to      2nd Bidding
                                                                                             2nd       to Negotiated
   Date                               Particulars                           Amount         Bidding     Procurement
06/05/2024   Supplies and materials needed for various projects of City   ₱ 481,925.63        23            63
             Engineering Office
09/26/2024   10 units solar powered water pumping system                    1,089,320.00     42             77
11/25/2024   Improvement of Brgy. Multi-Purpose Building, Brgy. San         1,212,006.54     28             82
             Isidro
12/13/2024   Mixing sand & gravel and aggregate base course for Major        136,260.00      49            224
             Repair of Multi-purpose Pavement and Stage at Sitio Lower
             Datong, Tabuan, 1st Revision, Bayawan City
                                         Total                            ₱2,919,512.17                     `
              (See complete details in Appendix 3)

             11.2.2.4 There was also no documentary evidence indicating that the BAC
                      formally requested an extension following the failure of the
                      bidding process. In the absence of such a request, the delay in
                      resorting to an alternative mode of procurement may be deemed a


                                                                                                                  65
