Meta PixelAnnual Audit Report 2024 — Municipality of Bacong — Page 79

Page 79 of 113

Page 79
Ref.

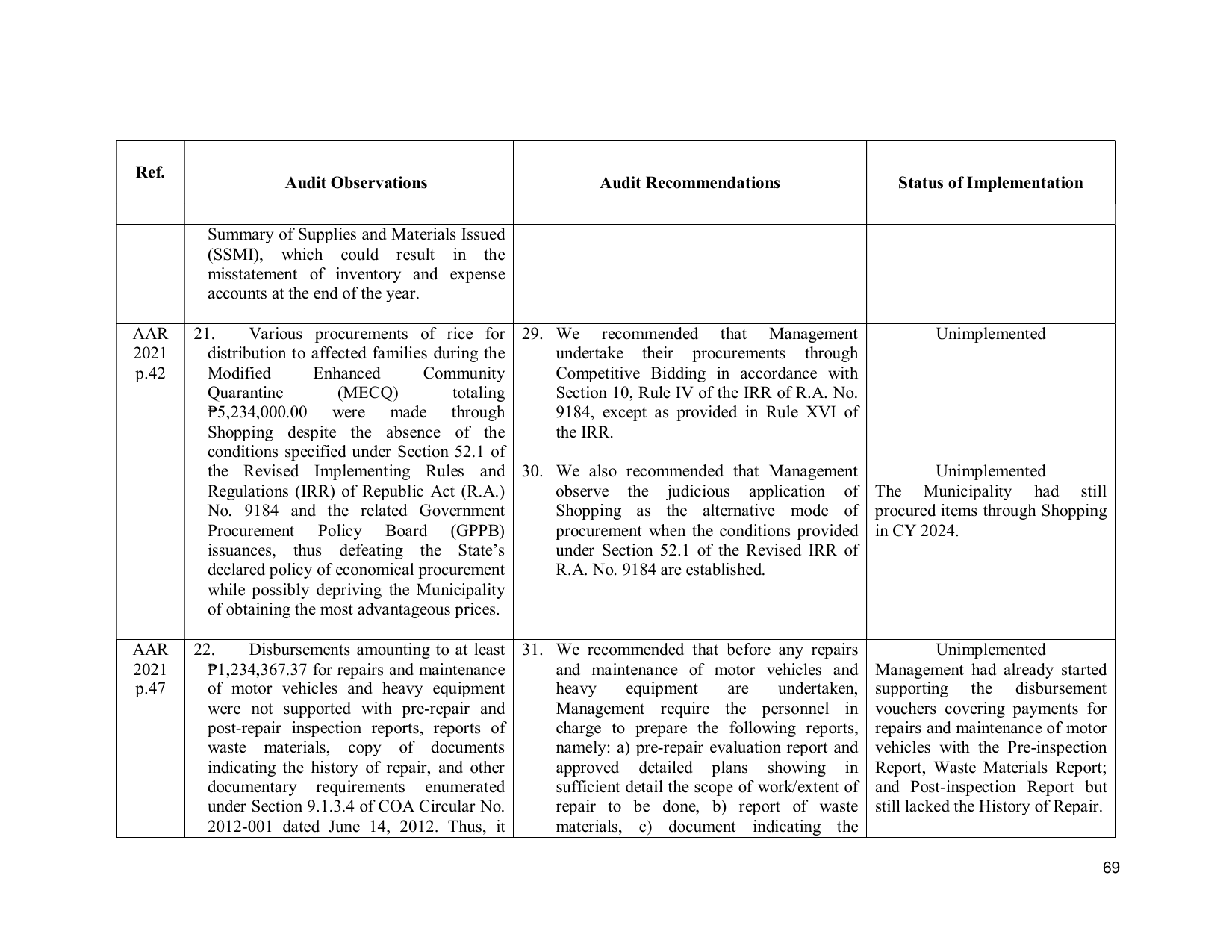

                   Audit Observations                          Audit Recommendations                      Status of Implementation


        Summary of Supplies and Materials Issued
        (SSMI), which could result in the
        misstatement of inventory and expense
        accounts at the end of the year.

AAR    21.      Various procurements of rice for 29. We recommended that Management                    Unimplemented
2021     distribution to affected families during the undertake their procurements through
p.42     Modified        Enhanced        Community    Competitive Bidding in accordance with
         Quarantine          (MECQ)          totaling Section 10, Rule IV of the IRR of R.A. No.
         ₱5,234,000.00 were made through              9184, except as provided in Rule XVI of
         Shopping despite the absence of the          the IRR.
         conditions specified under Section 52.1 of
         the Revised Implementing Rules and 30. We also recommended that Management                    Unimplemented
         Regulations (IRR) of Republic Act (R.A.)     observe the judicious application of The Municipality had still
         No. 9184 and the related Government          Shopping as the alternative mode of procured items through Shopping
         Procurement Policy Board (GPPB)              procurement when the conditions provided in CY 2024.
         issuances, thus defeating the State’s        under Section 52.1 of the Revised IRR of
         declared policy of economical procurement    R.A. No. 9184 are established.
         while possibly depriving the Municipality
         of obtaining the most advantageous prices.

AAR    22.     Disbursements amounting to at least 31. We recommended that before any repairs                    Unimplemented
2021     ₱1,234,367.37 for repairs and maintenance     and maintenance of motor vehicles and           Management had already started
p.47     of motor vehicles and heavy equipment         heavy      equipment      are    undertaken,    supporting the disbursement
         were not supported with pre-repair and        Management require the personnel in             vouchers covering payments for
         post-repair inspection reports, reports of    charge to prepare the following reports,        repairs and maintenance of motor
         waste materials, copy of documents            namely: a) pre-repair evaluation report and     vehicles with the Pre-inspection
         indicating the history of repair, and other   approved detailed plans showing in              Report, Waste Materials Report;
         documentary requirements enumerated           sufficient detail the scope of work/extent of   and Post-inspection Report but
         under Section 9.1.3.4 of COA Circular No.     repair to be done, b) report of waste           still lacked the History of Repair.
         2012-001 dated June 14, 2012. Thus, it        materials, c) document indicating the

                                                                                                                                         69
